PLANNING: Design
Services, Blue Prints, Permits
Energy Start Planning-Preconstruction Inspection
 |
|
3D Views Exterior-choose
finishes

3D Views Interior-choose finishes 7 days

2D
Blue Prints, obtain permits 7 days
 |
|
SITE PREP 2 days |
|

Home Positioning 1 day

SITE WORK 5 days
 |
|
Site prep and tree
removal 1 day |
|
 |
|

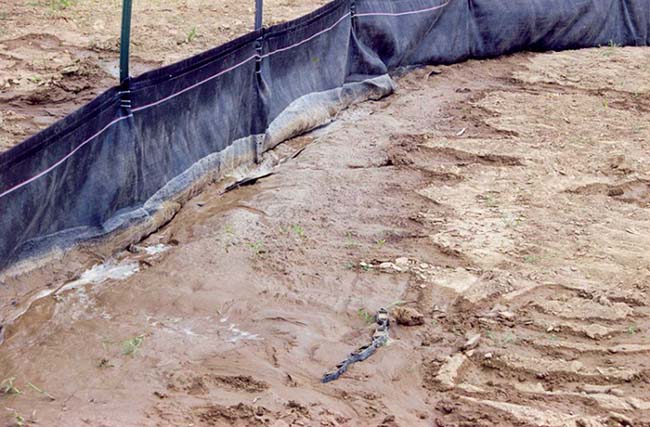

SILT FENCE 1 day |
|
 |
|
Driveway, properly
slopped and compacted 1 day |
|
 |
|
FOOTING, proper
depth, width compaction-1
day |
|
 |
|
Utilities 5-10 days |
|
 |
|
Reinforce Footing,
correct steel size -1 day |
|
 |
|
Pour Concrete, proper
PSI, slump and temperature-1 day |
|
 |
|
Sock Pipe, to prevent
drainage issues-1 day |
|
|
|
FOUNDATION:
precast concrete, pre-engineered-1 day
|
|

FOUNDATION: CMU (block), proper temperature, level, plumb,
joint size-1 day
 |
|
FOUNDATION: termite
pretreatment-1 day |
|
 |
|
WATERPROOFING
SERVICES: Foundation spray with water caring and insulating membrane-2
days |
|
 |
|
WATERPROOFING
SERVICES: Envelope, windows and penetrations properly sealed-3 days |
|
  |
|
FRAMING:14-21 days
By optimizing framing design, we can greatly
reduce energy losses from thermal bridging through the exterior walls.
To accomplish this:
• Employ specific framing layouts
to eliminate unnecessary framing members
• Make sure the headers are sized
correctly
• Locate openings to match framing
members
•
Use
optimum value engineered (OVE) techniques, such as turned-stud corners,
stand-off wall
intersections and
optimized window locations, to reduce thermal bridging in corners and
wall
• Panelize wall sections to minimize confusion in the field
|
|

Increase the dimension of the wall
framing, typically from 2x4 framing to 2x6 framing
The thicker the studs,
the more energy-efficient the wall system, provided that the wall cavity
is properly insulated. While increasing the dimension of the wall
framing will require design changes, it adds little or no cost to
traditional, 2x4 framing methods. Features of the design could include
inline framing at 24 inches on center; location of first-floor headers
to the rim area; and incorporation of optimized framing techniques to
limit framing member count.
  |
|
Framing: energy
efficient techniques:
insulated headers and
reflective sheathing |
|

Radiant Barrier

|
|
CONCRETE FLATWORK,
radon and moister barriers, reinforcements 1 day |
|
 |
|
Broom finish driveway
2 day |
|
 |
|
Slick Finish
Basement/Garages 1 day |
|
 |
|
Stamp Back Patio/
Front Porch 2 day |
|
  |
|
ELECTRICAL SYSTEMS 8
days |
|
 |
|
PLUMBING SYSTEMS 9
days |
|
 |
|
HVAC SYSTEM 8 days |
|

|
|
ROOFING , insure
proper felting and waterproofing-5 days |
|


 |
|
INSULATION. insure
proper ventilation- 7 days |
|
   |
|
Energy
Efficiency Air Sealing and Caulk Package-1 day
Ensure a tight seal throughout the structure |
|
 |
|
GYPSUM drywall) |
|
GYPSUM
drywall -
Screws only instillation to prevents pops- 26 days

GYPSUM drywall -
Moister resistant on he bottom, because of contact with concrete floor
|
|
BRICK |
|
Water proofing,
control joins, expansion joints, weep holes, flashing, proper air space,
tie-ins, proper joint size, lintels, slanting...
,
 |
|
Stone |
|
Proper water proofing and sheathing protection behind it

Arches and Design  |
|
Steps |
|
To code safety installation and proper settlement prevention
 |
|
SIDING: proper
drainage, flashing, caulking, staggering- 21 days |
|
 |
|
GUTTERING 2 days |
|
 |
|
CABINETRY. proper
blocking, level and fastening |
|

 |
|
COUNTERTOPS-2 days |
|
|
|
INTERIOR TRIM-14 days |
|

  |
|
STAIR SYSTEM: 7-14
days |
|

|
|
WOOD FLOORING install
perpendicular to floor system and protect, insuring proper moister
protection and staggering |
|
  |
|
CARPET. Proper
seaming, stretching and padding |
|
|
|
TILE & CERAMICS.
Water proofing, underlayment installation, fall assembly, sealing-21days |
|

   |
|
PAINT, 3 coat system
with tinted primer for scratch protection. 14-21 days |
|

|
|
HARDWARE DOOR &
CLOSET |
|
   |
|
SITE
IMPROVEMENTS 7 days |
|
Erosion control and retaining
Top Soil
Sod

Straw and Seed
 |
|
PLANNING: Design
Services, Blue Prints, Permits,
Energy Star Inspection


|
|
CONSTRUCTION CLEAN
UP, 5 days |
|

|
|
Punch list 5 days |
|
 |
|
Homeowners are
moving in... |
|
Click
Here To View Finished Photographs Of
This Home |
